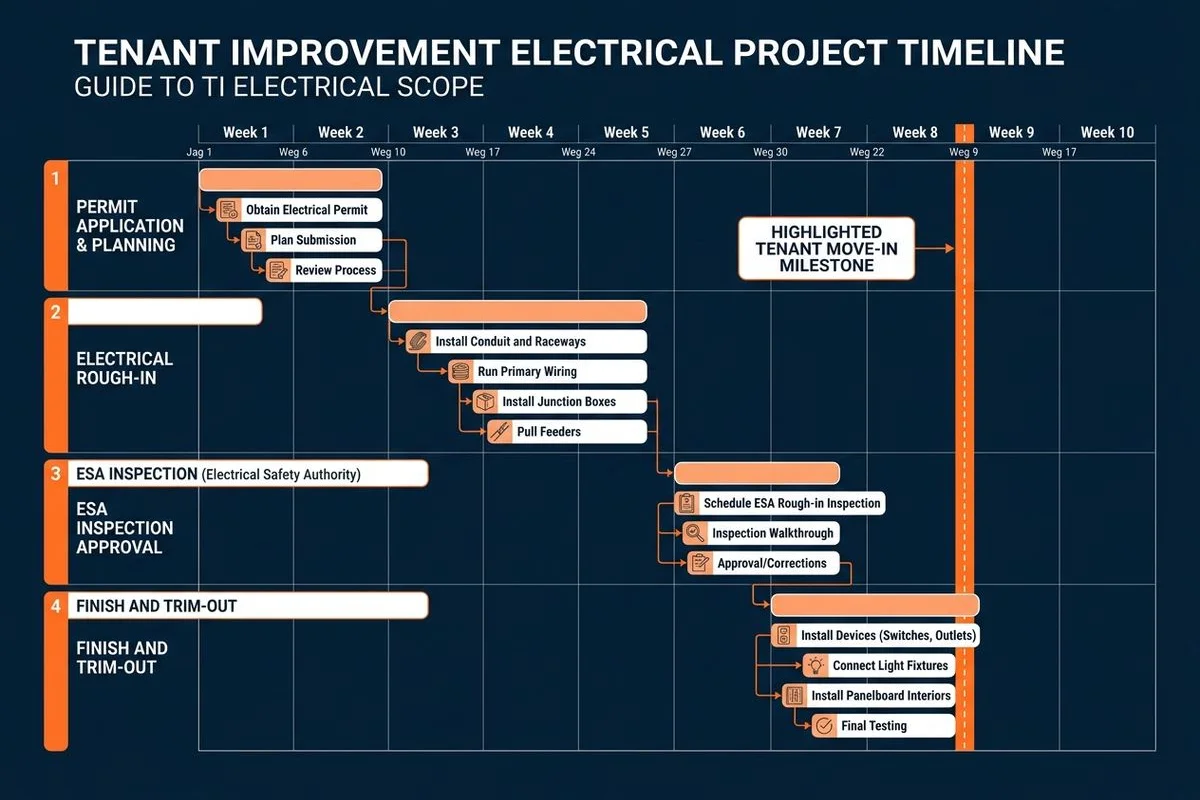

Project timeline graphic: TI scope phased around move-in date

Capture landlord/property-manager traffic during tenant turnover.

You know how unpredictable tenant improvement electrical toronto projects get in older buildings.

Our teams constantly see landlords facing unexpected wiring bottlenecks right before a new lease begins. The dividing line between a fast turnover and a delayed opening usually comes down to knowing the current code requirements. Upgrading an outdated system avoids compliance issues and keeps the space competitive.

We will break down the specific Electrical Safety Authority requirements and share exact local costs. Let’s look at the data and explore a few practical ways to protect your property investment.

What This Guide Covers

Quick overview of the points worth knowing before you book any commercial ti electrical work:

1. Typical TI electrical scope (lighting, outlets, sub-panel, demising)

Older commercial spaces in Toronto built before the 1990s often operate on limited 60-amp or 100-amp service. Our crews frequently find outdated Federal Pacific Stab-Lok or Zinsco panels in these properties. The Electrical Safety Authority flags both brands as fire risks, which prompts most insurers to deny coverage.

You must upgrade to a modern 200-amp service to handle new commercial equipment during a ti scope toronto project. In 2026, a standard 100-amp to 200-amp upgrade locally typically costs between $2,500 and $4,500. This price covers the new panel, breakers, labour, and mandatory utility coordination.

We always advise property owners to plan ahead for utility delays. Toronto Hydro currently requires a two to four week lead time to schedule a service disconnect.

Panel TypeSafety StatusTypical Action Required
Federal Pacific Stab-LokFire Risk (ESA Flagged)Full Replacement
ZinscoFire Risk (ESA Flagged)Full Replacement
Modern 200ACode CompliantRegular Maintenance

2. Permit and ESA scheduling around tenant move-in dates

Every commercial electrical modification in Ontario requires proper notification to the Electrical Safety Authority. Our licensed electricians file this paperwork before any wires get touched. Homeowners or landlords who pull the permit themselves take on massive financial liability. If an unpermitted worker gets hurt, you become personally responsible.

Insurance companies routinely deny claims linked to unpermitted work. The base ESA permit fee typically runs $160 to $180 just for the initial notification. Complex tenant fitup electrical jobs with multiple inspections will push that total closer to $500.

We build these inspection costs directly into the initial quote. You will never see a surprise bill from the safety authority later.

  • Contractor must hold a valid ECRA/ESA license number.
  • Permits must be filed electronically prior to construction.
  • Final ESA Certificate of Acceptance is mandatory for insurance.
  • Do-it-yourself permits void contractor liability.

3. After-hours work options

Tight leasing schedules often force landlords to consider overnight construction. Our teams handle after-hours commercial work carefully to avoid expensive municipal penalties. The Toronto Chapter 591 Noise Bylaw strictly limits construction activity.

Standard noisy work is only legally permitted Monday through Friday from 7 AM to 7 PM. Saturdays offer a slightly shorter window from 9 AM to 7 PM. You cannot authorize any construction noise on Sundays or statutory holidays.

We have seen landlords hit with daily fines starting at $900 for violating these noise rules. You can apply for a noise exemption permit for overnight retail shutdowns.

“Violating the Toronto Chapter 591 Noise Bylaw carries an initial penalty of $900, with fines compounding daily for ongoing overnight infractions.”

4. Coordinating with HVAC, plumbing, and finishes

Electrical installations do not happen in a vacuum during a full unit renovation. Our project managers coordinate closely with plumbers and HVAC technicians to pass the rough-in inspections. The ESA inspector must review all new wiring before the drywall contractor closes the walls.

Missing this inspection milestone requires tearing down brand new drywall. You must provide clear access to all junction boxes and sub-panels.

We establish a strict sequence of operations to prevent trade collisions.

  1. Demolition and framing completion.
  2. HVAC ductwork and plumbing pipe installation.
  3. Electrical wire pulling and box mounting.
  4. ESA rough-in inspection approval.
  5. Insulation and drywall finishing.

5. Fixed-fee vs T&M billing

Cost overruns destroy the profitability of a new lease agreement. Our company recommends fixed-fee contracts for standard tenant improvements. Time and materials billing leaves you exposed to unpredictable hourly charges.

In 2026, a licensed Journeyman electrician in Toronto bills between $100 and $150 per hour. Master Electricians command $150 to $200 per hour for complex diagnostics. A simple service call carries a minimum charge of $100 to $200 just to show up.

We price the entire scope of work upfront to eliminate guesswork. This flat-rate approach guarantees your renovation budget stays intact.

Billing ModelCost PredictabilityBest For
Fixed-FeeHigh (Guaranteed Price)Standard Upgrades, Panel Swaps
Time & MaterialsLow (Varies by Hour)Troubleshooting, Unknown Issues

Ready for a Quote?

If you need to finalize the scope of your upcoming project, we are ready to assist. Our experts provide detailed estimates on commercial and residential spaces across the Greater Toronto Area. Every job features flat-rate pricing and includes proper permits filed under our authorized LEC name. You always receive the official Certificate of Acceptance upon completion.

Visit our commercial electrical page for the full scope of what we do. You can also contact us directly to schedule a site visit.
